OLT Equipment Room Quarterly Inspection Implementation Plan
About 747 wordsAbout 2 min
I. Case Introduction
Scenario Description
A city telecom broadband operator implements a quarterly OLT equipment room inspection system:
- Inspection Objects: Network-wide OLT (Optical Line Terminal) equipment room devices
- Inspection Frequency: Full coverage once per quarter
- Execution Requirements: Complete all equipment room inspections within the quarter
- Time Window: Executable at any time during the quarter
Core Value
- Ensure stable operation of core network equipment
- Reduce failure rates through preventive maintenance
- Meet telecom industry maintenance standards
- Optimize equipment lifecycle management
II. Plan Configuration
1. Create Inspection Plan
Operation Path:
- 【Inspection Management】→【Plan Scheduling】

- Click "New" button
Configuration Parameters:
| Parameter | Value | Description |
|---|---|---|
| Plan Name | OLT Equipment Room Quarterly Inspection | Clear identifier |
| Activation Status | Enabled | Auto-generate tasks |
| Inspection Route | Network-wide OLT Equipment Room Route | Predefined route |
| Start Date | 2025-Q1 First Day (e.g. 2025-01-01) | Must be quarter start day |
| Cycle Period | 3 months | Quarterly cycle |
| Trigger Date | 3 | Generate tasks 3 days in advance |
| Trigger Time | 22:00 | Generate next quarter's tasks at 22:00, 3 days before quarter end |
| Overtime Reporting | No | Cross-quarter completion not allowed |
| Offline Reporting | No | Offline operation not supported |
Key Setting Instructions:
Start date must be set to quarter start day (Jan 1/Apr 1/Jul 1/Oct 1)
III. Task Configuration
1. Single Task Configuration
Operation Steps:
- Locate target plan
- Click "Add Task" icon

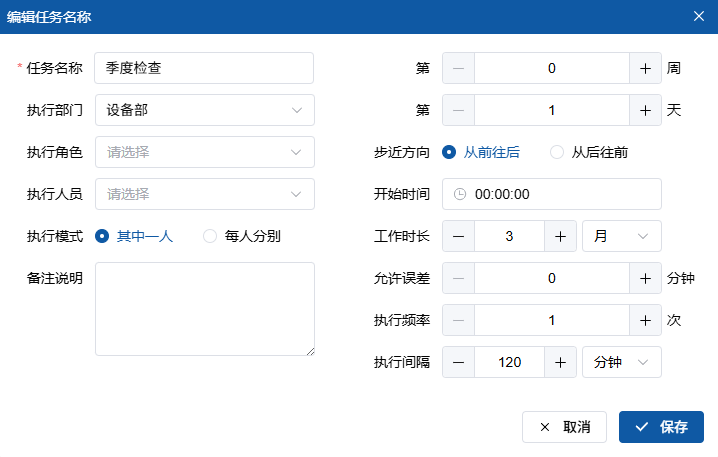

Parameter Configuration:
| Parameter | Value | Description |
|---|---|---|
| Task Name | Comprehensive OLT Equipment Inspection | Clear task content |
| Executing Personnel | Network Maintenance Group | Designated responsible team |
| Nth Day | 1 | First day of quarter |
| Start Time | 00:00 | Quarter start time |
| Working Duration | 3 months | Full quarter execution window |
| Execution Frequency | 1 time | Single task per quarter |
2. Configuration Analysis
- Time Window:
- Task validity: Quarter start day 00:00 to quarter end day 24:00
- Flexible execution: Complete within quarter
- Execution Requirements:
- Cover all OLT equipment rooms
- Execute according to standard checklist
- Record key indicators
IV. Task Generation and Execution
1. Automatic Generation Mechanism
- Generation Time: 22:00, 3 days before quarter end
- Generated Content: Next quarter's OLT equipment room inspection tasks
- Task Characteristics:
- Validity period: Full natural quarter
- Reminder settings: Push task reminders at quarter start
- Progress monitoring: Display completion rate
2. Manual Generation Operation
- Locate target plan
- Click
redo icon in operation column
- Set time range (e.g. 2025-Q1: 2025-01-01 to 2025-03-31)
- Click "Confirm" to generate immediately
3. Execution Process
- Plan Breakdown:
- Divide execution routes by region
- Develop monthly execution plan:
- First month: Complete 30% equipment rooms
- Second month: Complete 60% equipment rooms
- Final month: Complete 100% equipment rooms
- On-site Inspection:
- Equipment operational status check
- Environmental parameter monitoring (temperature/humidity)
- Power/UPS system detection
- Optical fiber connection quality test
- Data Reporting:
- Use specialized testing equipment
- Automatically synchronize test data
- Classified reporting of abnormal situations
- Quarterly Acceptance:
- System auto-generates quarterly report
- Completion warning before 20th of final month
- Complete all inspections before quarter end
V. Best Practices
1. Execution Strategy
| Time Period | Execution Focus | Target |
|---|---|---|
| Days 1-30 | Core hub equipment rooms | 30% completion |
| Days 31-60 | Regional backbone equipment rooms | 60% completion |
| Days 61-90 | Edge access equipment rooms | 100% completion |
2. Optimization Suggestions
- Digital Management:
- Equipment room QR code identification
- Mobile scanning input
- Auto-generate electronic reports
- Preventive Maintenance:
- Combine with equipment operational data
- Predictive replacement of vulnerable parts
- Establish equipment health records
- Standardized Operations:
- Develop checklist templates
- Key parameter threshold warnings
- Build typical case library
3. Exception Handling
| Exception Type | Solution |
|---|---|
| Equipment alarm | Immediately initiate emergency repair |
| Equipment room abnormality | On-site verification within 24 hours |
| Progress delay | Activate backup team support |
| New equipment room | Manually add inspection task |
VI. Precautions
1. Key Configuration Requirements
- Quarter Definition: Define natural quarters (Jan-Mar/Apr-Jun/Jul-Sep/Oct-Dec)
- Equipment Room List: Update list at quarter start
- Permission Management: Executors need security certification
- Data Security: Encrypted transmission of test data
2. Industry Standards
- Inspection Specifications:
- Comply with YD/T 1627 "Technical Requirements for Optical Line Terminal Equipment"
- Meet GB/T 22239 "Basic Requirements for Network Security Level Protection"
- Record Requirements:
- Retain inspection records for at least 2 years
- Include equipment serial number/software version
- Electronic signature of maintenance personnel
3. Safety Requirements
- Comply with equipment room access system
- Electrostatic protection before operation
- Two-person presence during backup power testing
- Remote monitoring of sensitive operations
